In the PJM grid region, 102 GW of solar could be deployed by sharing points of interconnection now used either by fossil generators that operate below a 15% capacity factor, or by solar and wind plants that use less than 20% of their interconnection capacity.
That’s the conclusion of a working paper by two University of California researchers.
Solar and wind plants in the region could also host 24 GW of storage, which could be charged by new renewable generation sharing the point of interconnection.
These amounts of solar and storage, plus 28 GW of wind power, could be added without building new transmission infrastructure, and “bypassing” PJM’s “congested” interconnection queues, the researchers say.

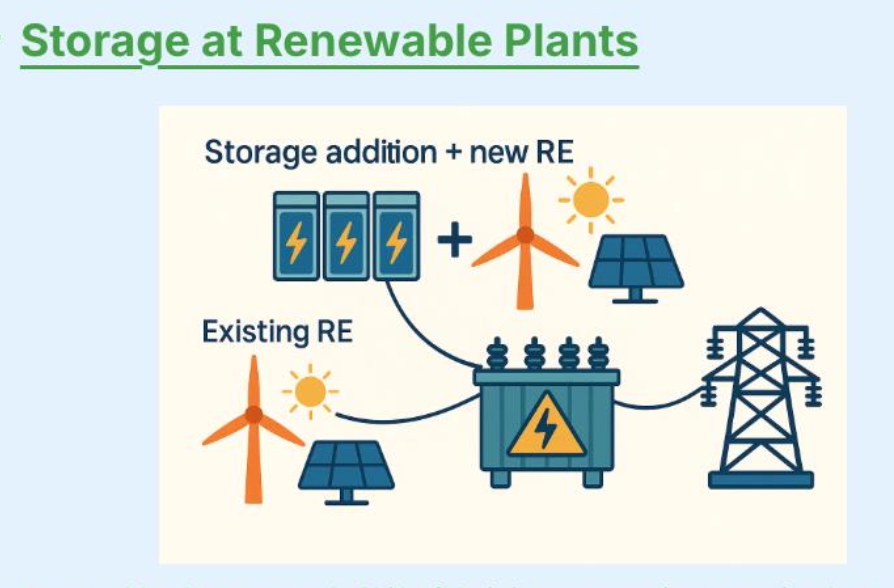

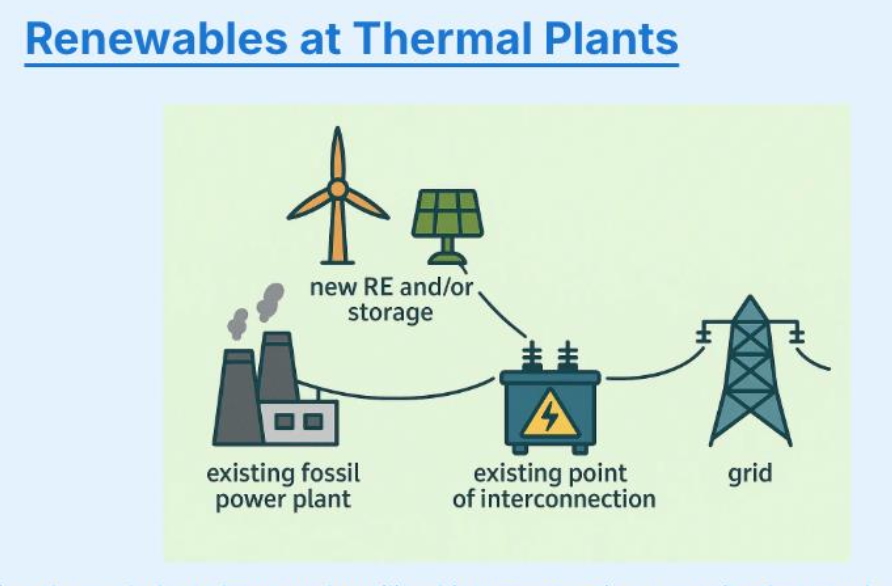

To illustrate the concept, the paper provides the two images shown below. At any given time, the combined output of the generators sharing a point of interconnection could not exceed the capacity of the point of interconnection. The second image illustrates that adding storage at solar sites enables more solar at those sites, because the added batteries store the additional solar electricity for discharge at night.
The researchers report that PJM has 95 GW of solar capacity “stuck” in its interconnection queues, along with 37 GW of standalone storage capacity and 25 GW of wind capacity.
The clean energy additions available through shared points of interconnection could connect to the grid within 1-2 years, the researchers say, compared to 5-7 years for projects needing a new point of interconnection.
Adding clean energy by sharing interconnection could help address a “looming” 25 GW capacity shortfall in the PJM region by 2030 largely due to data center demand, the researchers say. They add that natural gas plants ordered now are unlikely to be operational before 2030-2032.
A PJM spokesperson said that “PJM continues to advance initiatives to make it easier to leverage existing interconnection capability, such as changes to Surplus Interconnection Service, which the Federal Energy Regulatory Commission approved to utilize the unused portion of interconnection service for facilities that do not operate continuously.”
Buildable areas

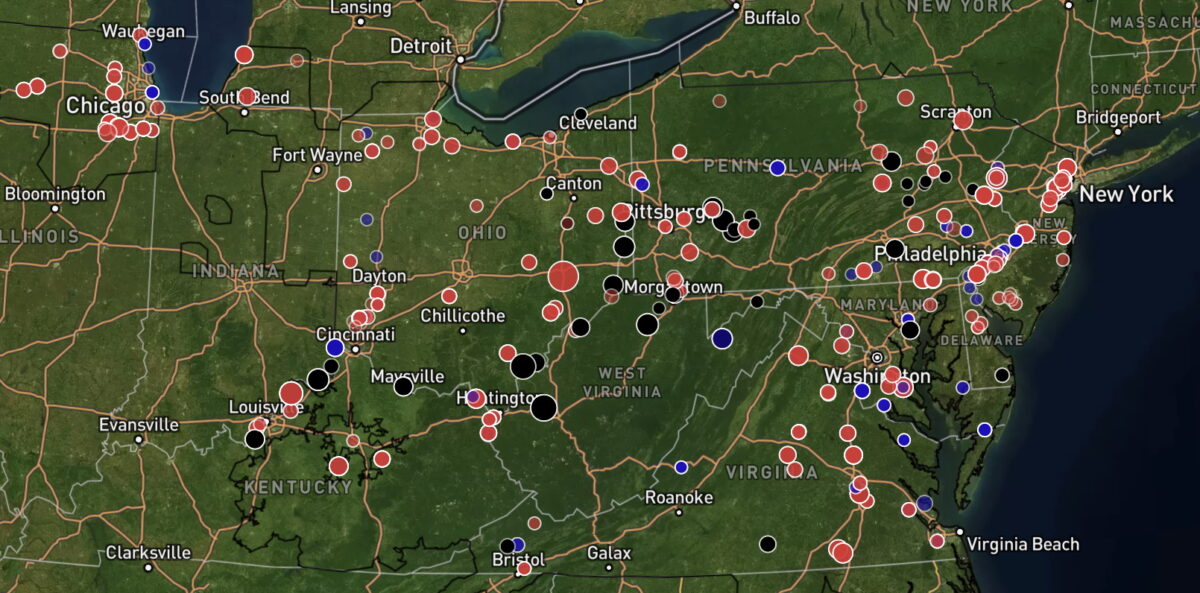

A dashboard accompanying the working paper shows plant level details on surplus interconnection potential. “If you select a plant from the left filters” of the dashboard, said researcher Umed Paliwal, “you can also see the land use button pop up on the right-hand side. Clicking that button shows land use near the plant.” The land uses are color-coded, with one color indicating buildable areas for clean energy projects near each potential shared point of interconnection.
Among the paper’s policy recommendations are:
- PJM should create a pro forma Surplus Interconnection Service Agreement, modeled on one used by grid operator MISO.
- Federal regulators and PJM must create a clear pathway for a surplus user to obtain permanent interconnection rights when a host generator retires.
California and nationwide
A similar paper from UC Berkeley on sharing points of interconnection in California prompted a proposal for the state to act promptly to ensure that clean energy developers could quickly add 23 GW of renewables.
Nationwide, sharing points of interconnection could enable 500 GW of solar, a team of UC Berkeley researchers reported last year.
The new paper focused on PJM is titled “Existing power plants sharing grid access with new resources can lower costs and double PJM’s generating capacity.”
This content is protected by copyright and may not be reused. If you want to cooperate with us and would like to reuse some of our content, please contact: editors@pv-magazine.com.
By submitting this form you agree to pv magazine using your data for the purposes of publishing your comment.
Your personal data will only be disclosed or otherwise transmitted to third parties for the purposes of spam filtering or if this is necessary for technical maintenance of the website. Any other transfer to third parties will not take place unless this is justified on the basis of applicable data protection regulations or if pv magazine is legally obliged to do so.
You may revoke this consent at any time with effect for the future, in which case your personal data will be deleted immediately. Otherwise, your data will be deleted if pv magazine has processed your request or the purpose of data storage is fulfilled.
Further information on data privacy can be found in our Data Protection Policy.
